The Photo's below will outline construction
from start to finish including timelines
September 8th, Wednesday
Day 1 - Permits pulled at building department and scheduled footer inspection for tomorrow morning. All footers and pier pads dug out. Rebar installed and tied.
September 9th, Thursday
Day 2 - Received am footer inspection and passed. Poured all footers and pier pads.
September 10th, Friday

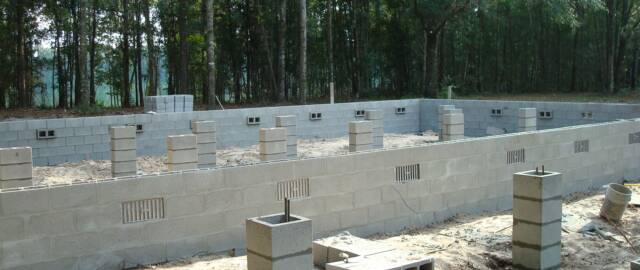

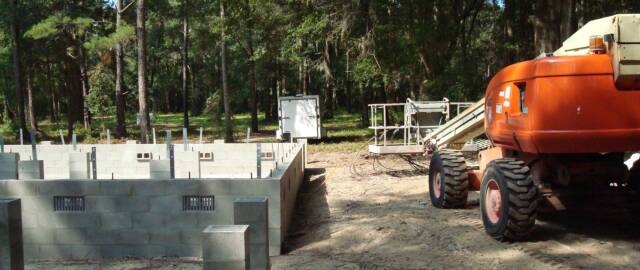

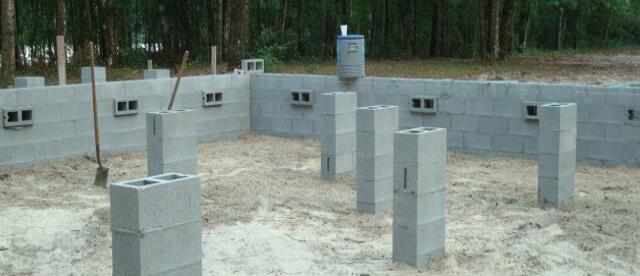

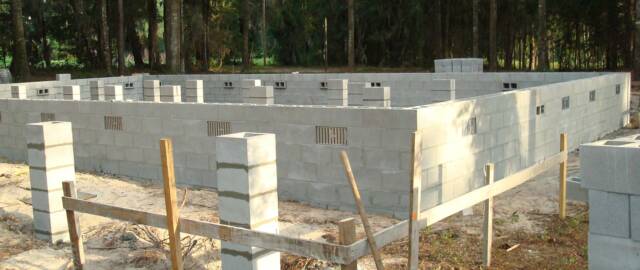

Day 3 - Scheduled Monday am inspection for tie-beam and slab. Installed all block on crawlspace foundation including pier pads. Electricians onsite and set temporary electric pole for Mondays inspection.
September 11th, Saturday
Day 4 - Cut out dirt and graded crawlspace to place 4" slab after Mon. inspection. Finished placing rebar in tie-beam.
September 12th, Sunday

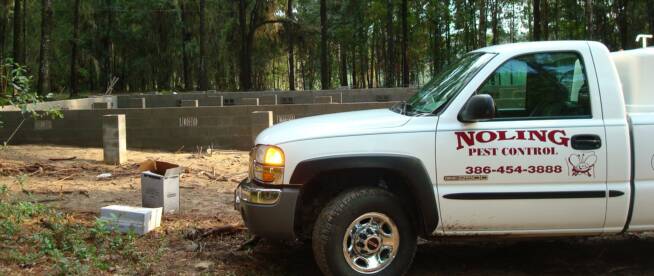

Day 5 - Sprayed with water truck and compacted to grade. Applied soil pest control treatment. Installed visqueen to 4" slab area. Ready for tomorrow's am inspection.
September 13th, Monday

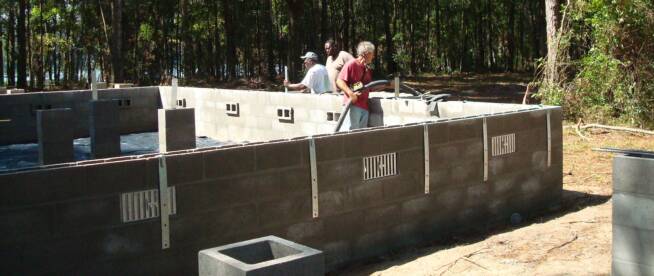

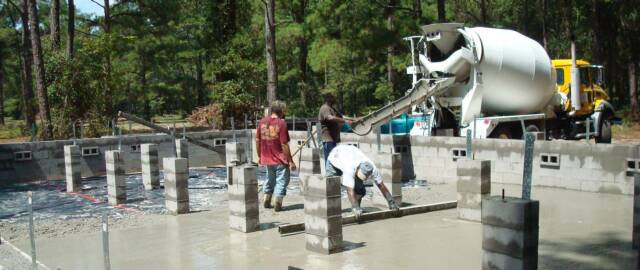

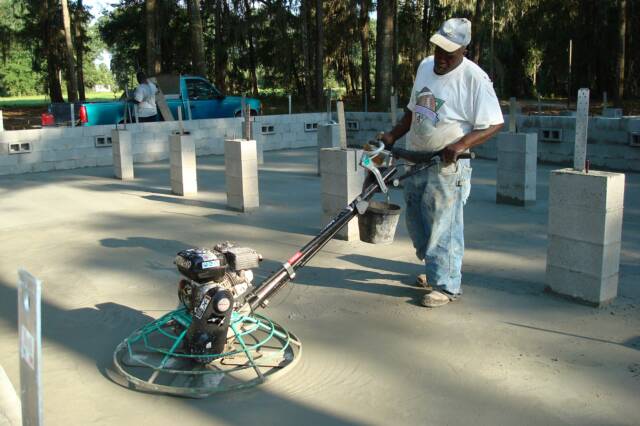

Day 6 - 9:30 Inspection with Building Department on slab, block cells, piers and tie- beam passed. Pumped concrete and filled block cells, piers and tie-beams. Set all strapping and j-bolts. Poured 4" slab inside of crawlspace.
This is a single story home 1664 sf. of heated space and features an 8ft. wide full length covered porch on the front including a 12ft. wide full length covered porch across the back.
September 14th, Tuesday

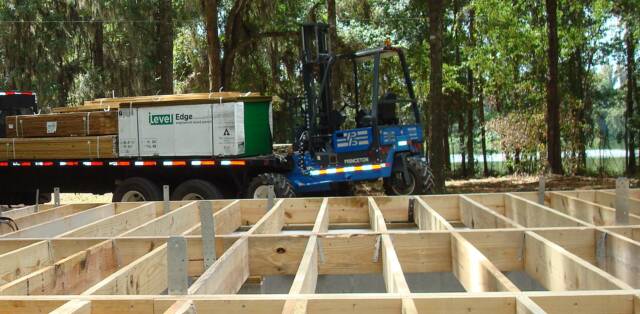

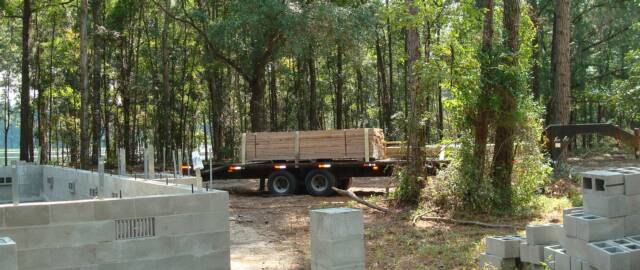

Day 7 - 1st floor system materials and crew's tool trailer delivered today.
Trimming tree branches overhanging home.
September 15th, Wednesday

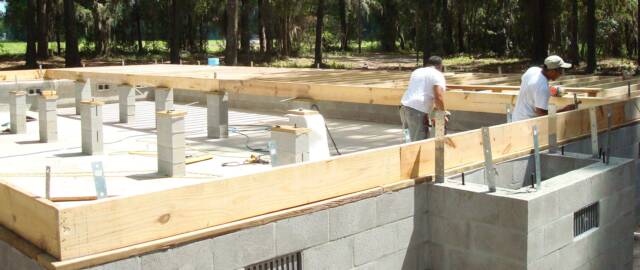

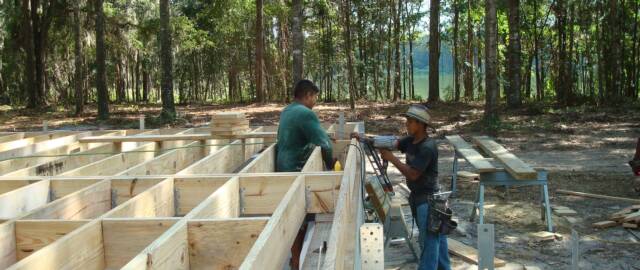

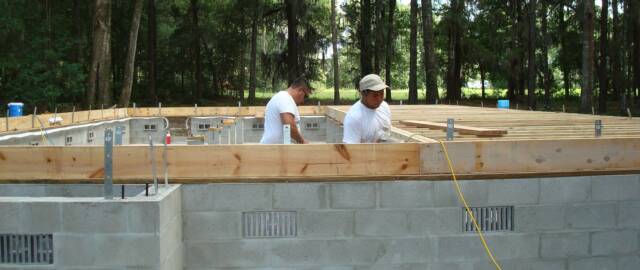

Day 8 - Crew onsite building floor system.
September 16th, Thursday

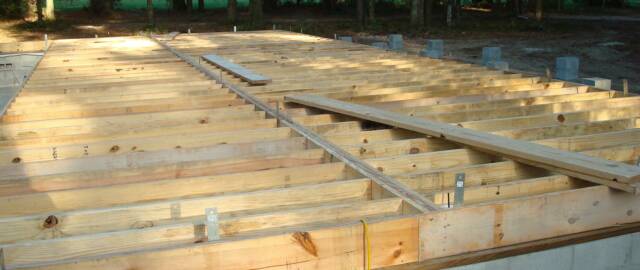

Day 9 - Crew completed floor system and ready for tomorrows am inspection. Recieved covered porch materials.
September 17th, Friday

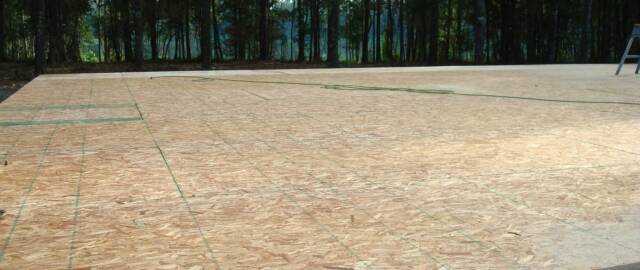

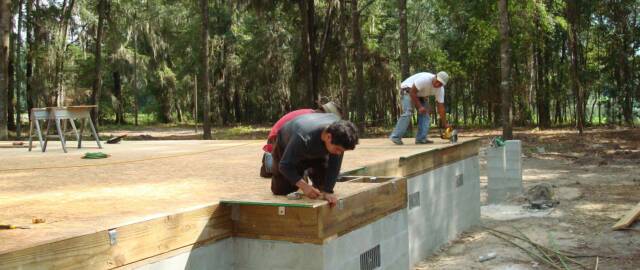

Day 10 - Waited till 1:30 for sub-floor framing inspection and release of temp. electric. Everything passed. Installed and completed sub-floor sheathing.
September 18th, Saturday

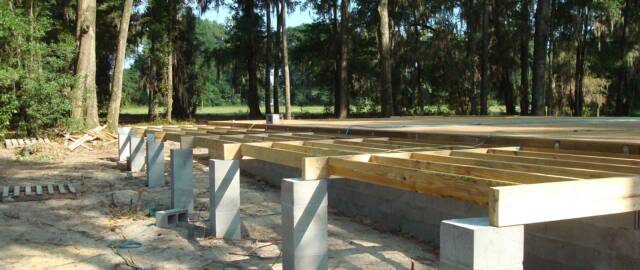

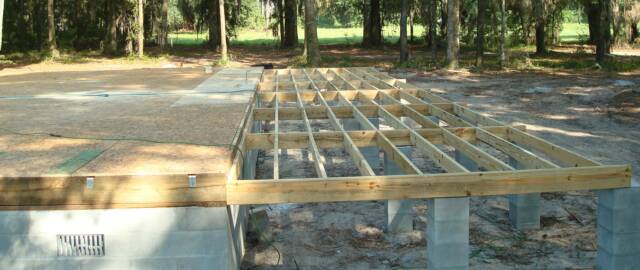

Day 11 - Worked on decks for front and back covered porches.
September 19th, Sunday
Day 12 - No work today.
September 20th, Monday

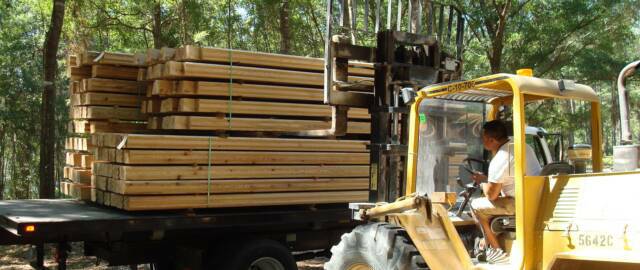

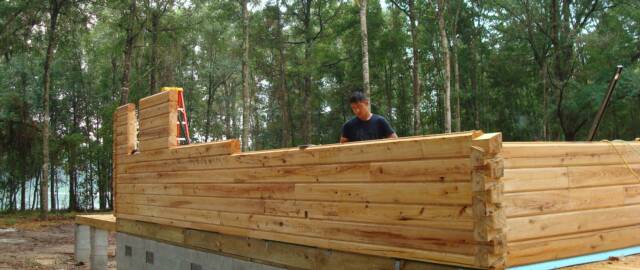

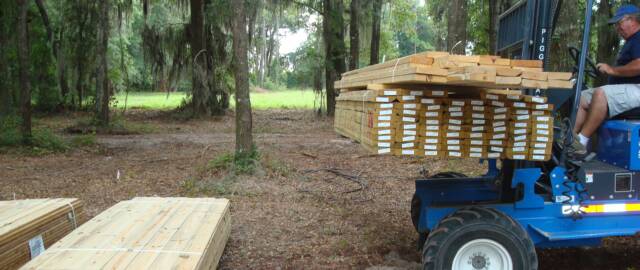

Day 13 - Installed decking to front covered porch. Received forklift and unloaded two truckloads of logs and post materials. Organized placement of materials and started laying logs.
September 21st, Tuesday

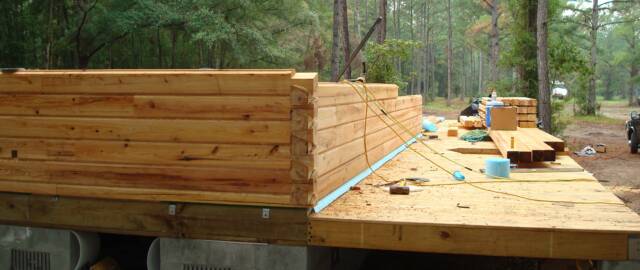

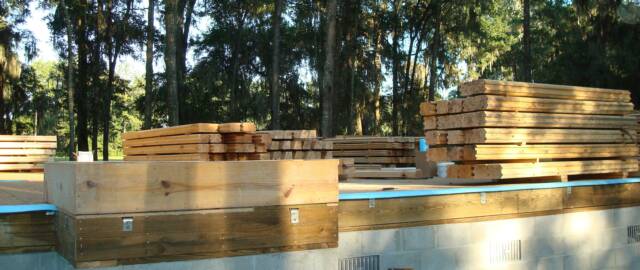

Day 14 - Crew stacking logs.
Copyright © 2014 Log Home Guys LLC.
This page was last updated: March 25, 2016
Complete Log Home Turnkey Construction Documentary including photo's outlining every aspect to building a Log Home from start to finish. Features all subcontractor trades from log home contractors, foundation to metal roof. This was designed to help future owners wanting to build a log home understand the many steps and to be better prepared.
Log Home Guys LLC. | 295 NW Commons Loop #115-300, Lake City, Florida 32055 | 866-306-1697
"The 100 Day Turnkey"
Shamrock Log Home Construction
