Log Home Construction From Start To Finish
The Log Home listed below under construction is our
Shamrock Log Home Model.
Day 34 to Day 49
October 11th, Monday

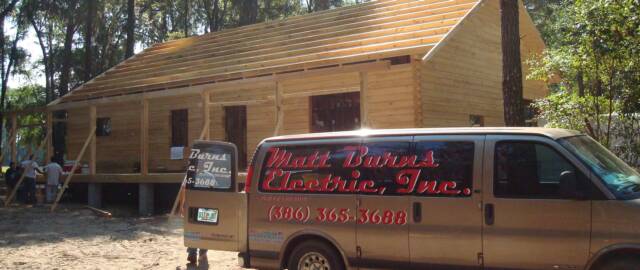

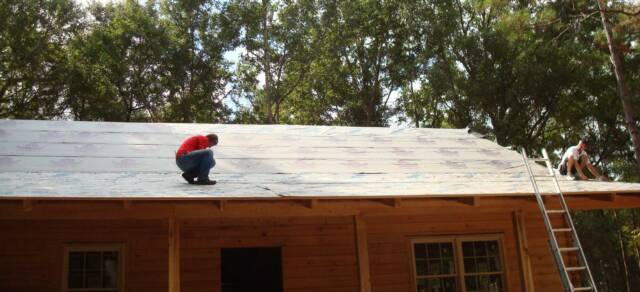

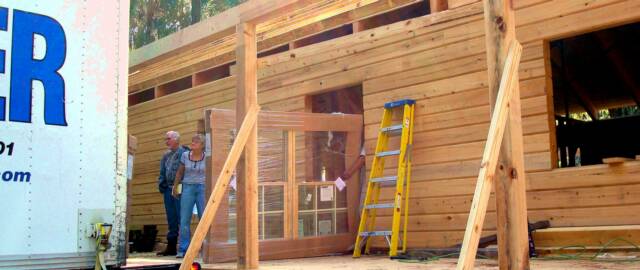

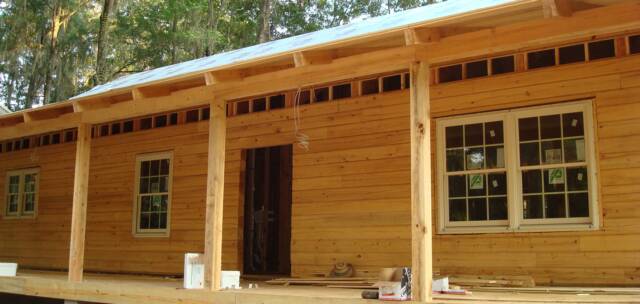

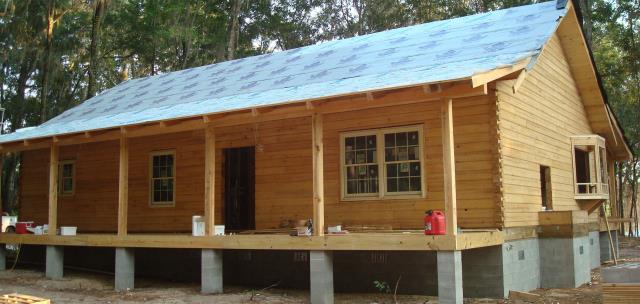

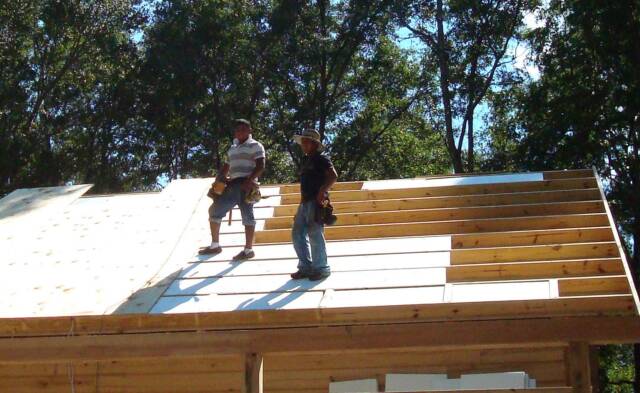

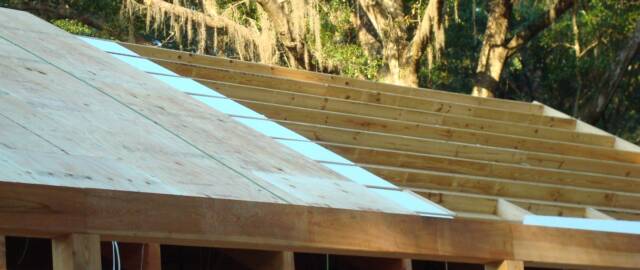

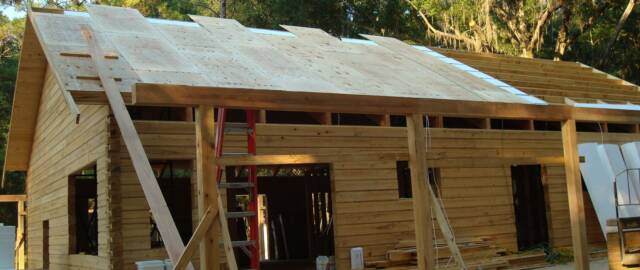

Day 34 - Electricians onsite met with the Owner's and laid out all electric and installed all ceiling drops with wiring rough. Exterior metal clad windows and doors delivered. Crew installing insulation, roof decking

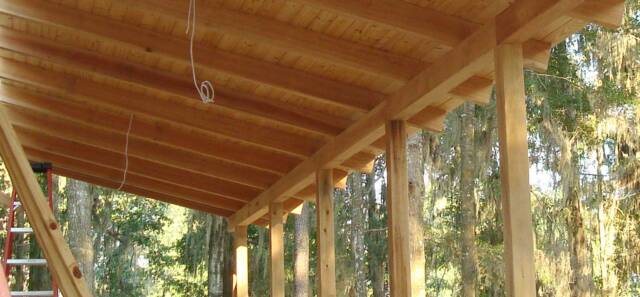

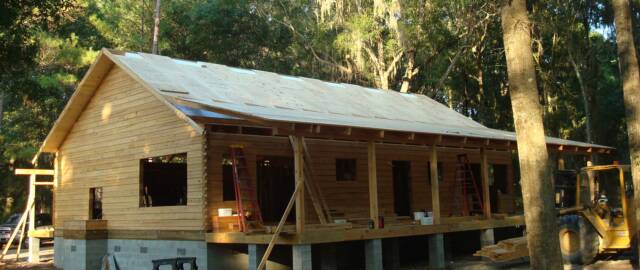

and working on porches.
October 12th, Tuesday
Day 35 - Crew installing insulation, roof decking
and working on porches. Building Dept. on site today and signed off on sheathing inspection.
October 13th, Wednesday
Day 36 - Crew working on porches.
October 14th, Thursday
Day 37 - Crew working on porches and installing roof under layment
October 15th, Friday

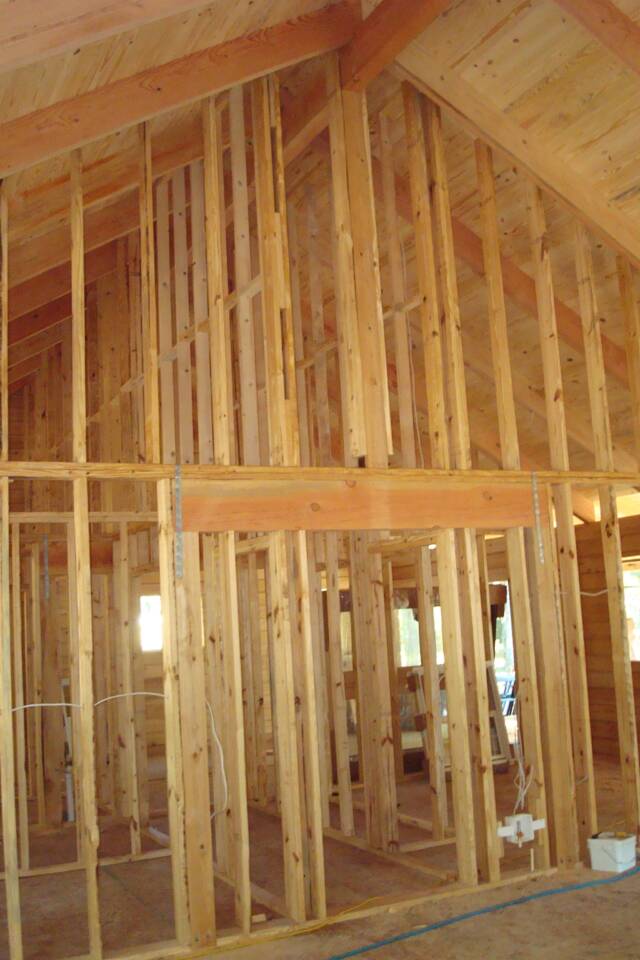

Day 38 - Crew working on interior wall framing. Plumbers onsite working on rough in.
October 16th, Saturday
Day 39 - Crew working on interior wall framing. Plumbers onsite working on rough in.
October 17th, 2010 Sunday - No Work
October 18th, Monday

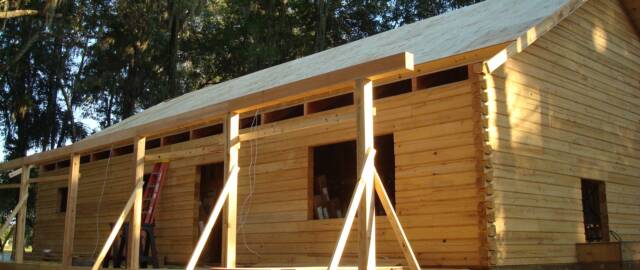

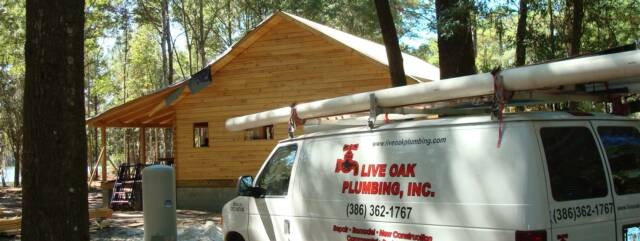

Day 41 - Crew working on window and door bucking and front covered porch system. Plumber onsite working on rough in.
October 19th, Tuesday
Day 42 - Crew working on window bucking and bay window. Plumbers onsite working on rough-in. Electricians onsite working on rough-in. Hardwood and tile subcontractor onsite measuring layout for finish floors and shower hops.
October 20th, Wednesday

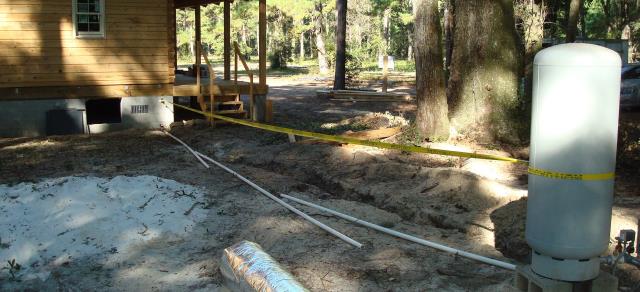

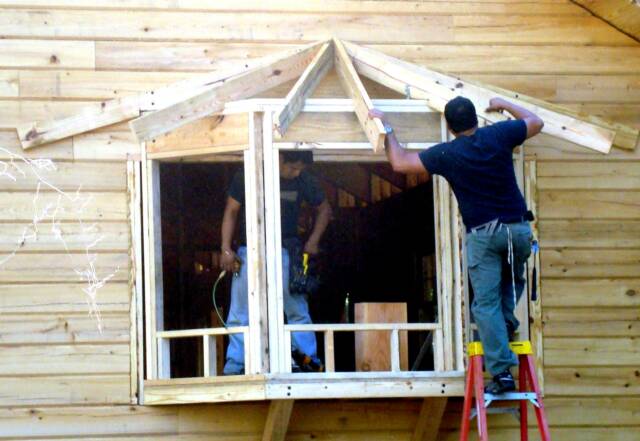

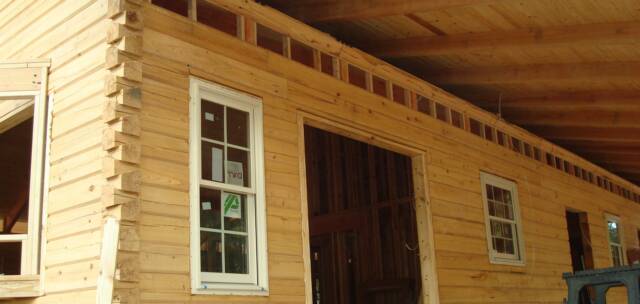

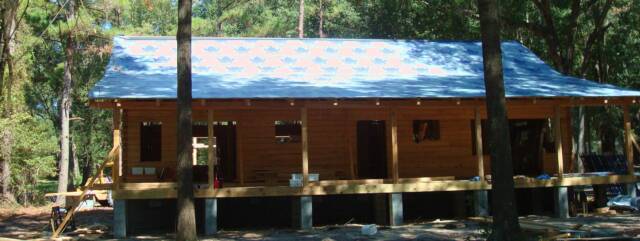

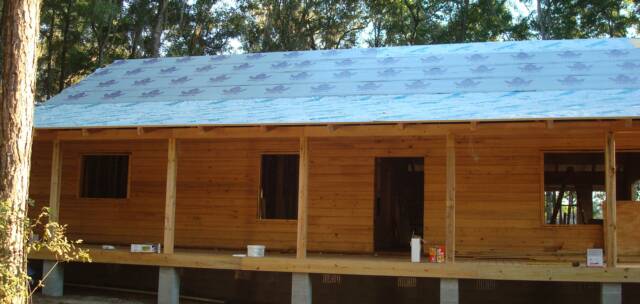

Day 43 - Crew installing windows. Framing bay window. Plumbers onsite working on rough-in and installing waterline to well.
October 21th, Thursday
Day 44 - Crew framing 6/0 x 6/10 doors. Completing log to roof transition. Framing bay window.
October 22nd, Friday

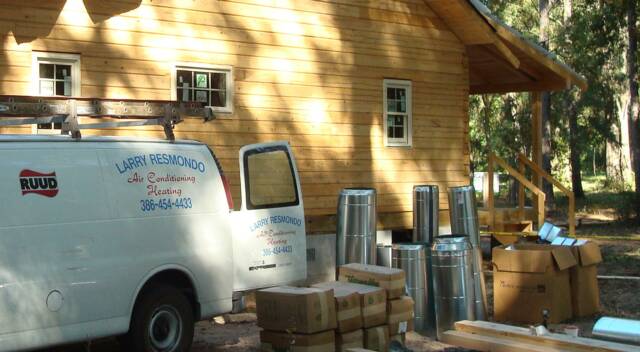

Day 45 - Crew working on misc. items, HVAC crew onsite, met with owner and laid out all vents/returns and installed duct work.
October 23rd, Saturday
Day 46 - Crew working on misc. items
October 24th, Sunday
Day 47 - No Work
October 25th, Monday
Day 48 - Crew working on misc. items, drop ceilings, elect. cutouts, finished sheathing bay window and set both 6/0 x 6/10 exterior doors. HVAC crew onsite, met with owner and laid out last 2 vents that were in conflict with floor structural members. "HVAC rough-in complete." Plumbers onsite, set tub and finishing rough-in. Metal roof contractor onsite taking finish roof measurements and ordered metal to be delivered tomorrow. Coordinated and completed all roof penetrations with roofing contractor (HVAC, Plumbing and Gas) Metal roof installation scheduled to start Wednesday.
October 26th, Tuesday
Day 49 - Crew working on misc. items and framing fireplace. " Plumbers onsite, finishing rough-in. Metal roofing delivered. Meeting onsite with owners to discuss porch rails and picket design.
Copyright © 2014 Log Home Guys LLC.
This page was last updated: March 25, 2016
Visit our page to learn how to build a complete log home or log cabin. You'll learn all the steps from day one to completion. Ready to move in.
Log Home Guys LLC. | 295 NW Commons Loop #115-300, Lake City, Florida 32055 | 866-306-1697
